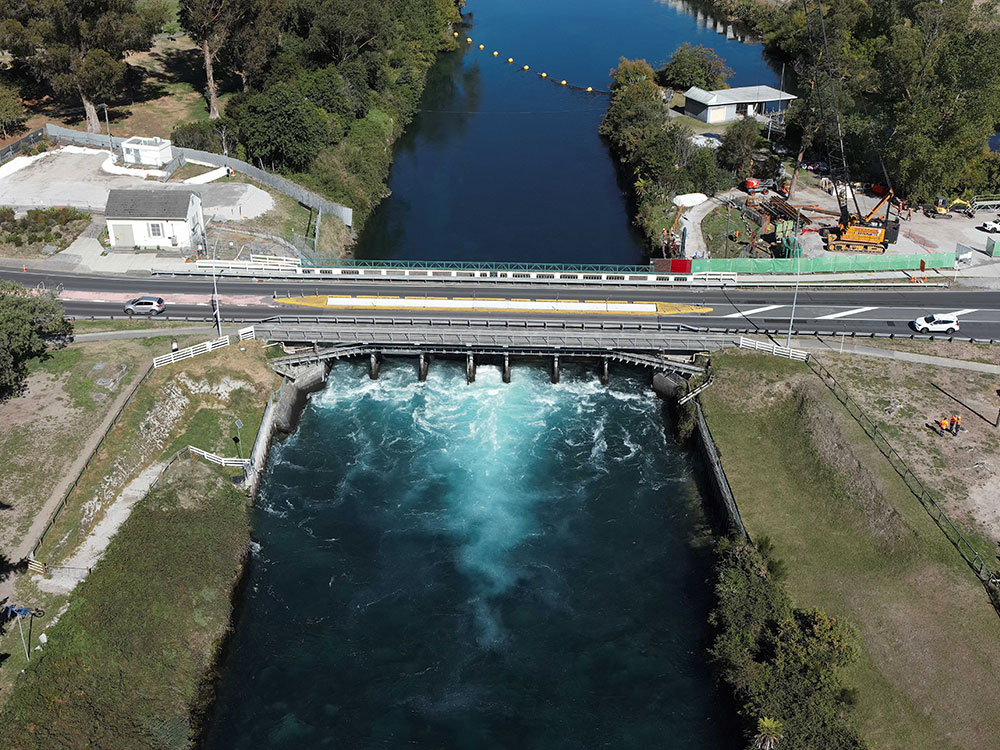

Mercury's Taupō Control Gates
Mercury owns and operates the Taupō Control Gates. It is a reinforced concrete structure built in 1941, on the bed of the Waikato River at the outlet of Lake Taupō.
The Control Gates regulate flows out of the lake and down the river to nine power stations downstream operated by Mercury, which form the Waikato Hydro System Catchment. The hydro system generates about 10% of New Zealand’s renewable energy demands.
While Mercury owns and operates the Control Gates, the surface of the bridge is owned by Taupō District Council for transport purposes.
Project Background
As part of Mercury’s ongoing Dam Surveillance programme, regular inspections of the Control Gates are carried out to ensure the structure is maintained, and structural integrity is ensured.

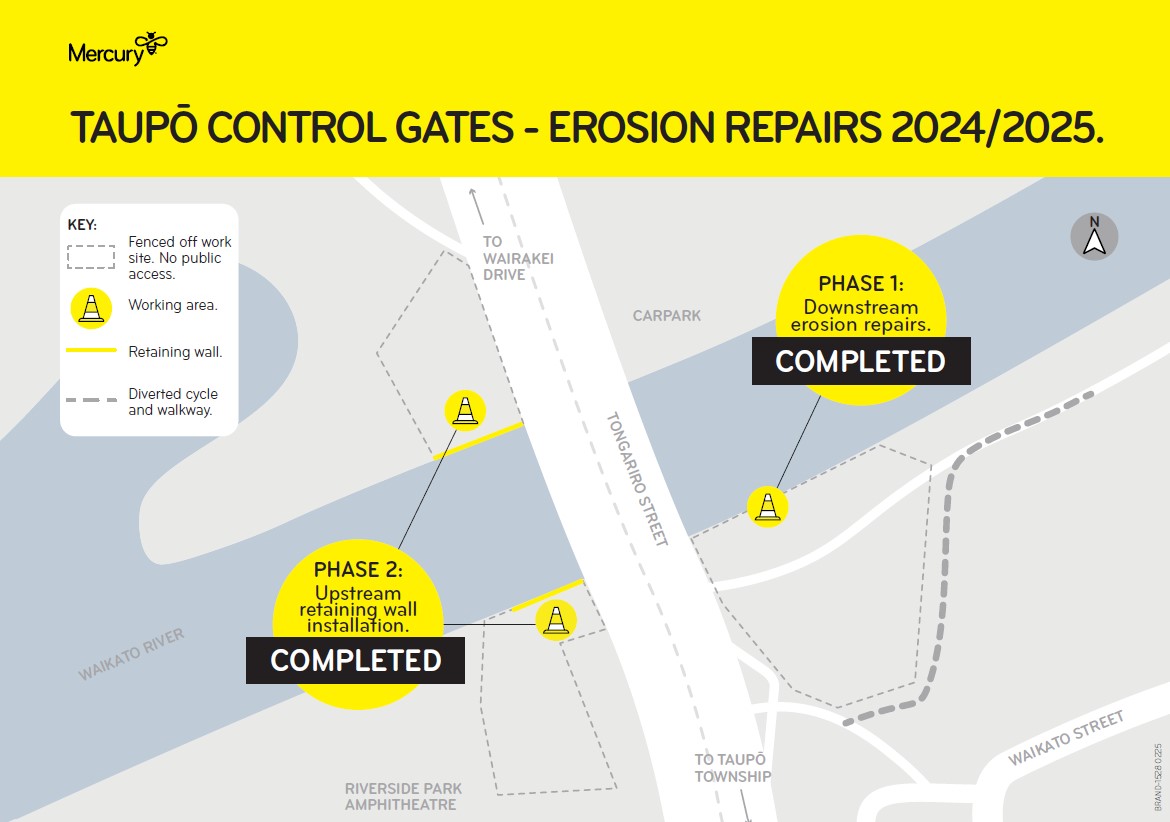

The inspections showed work needed to be done to address erosion on the river banks around the structure. To repair the erosion spots, we planned work to take place between August-December 2024 and February-June 2025. We also used this opportunity to complete the planned refurbishment of one set of Control Gates in the structure.
There were no immediate safety or operational risks to the road, to the bridge, or the way the water flows are managed through the Control Gates. But it wasimportantthis planned work was advanced to ensure the Control Gates can operate reliably.
Project Overview
Phase1 was completed in 2024. It involved installing new dam safety instruments around the structure, filling in an erosion spot which has formed downstream from the Control Gates, on the river's southern side. We also used this time to refurbish one of the sixControl Gates.
Phase 2 of the work was completed between February and June 2025 and involved erosion protection upstream of the Control Gates, on both sides of the river. Specialist equipment was used to install 12m-long sheets to protect the riverbanks from erosion.]
People can also contact the project team via email: TaupoControlGates@mercury.co.nz
Read more about the Control Gates here.

2025 Milestones
2024 Completed Milestones

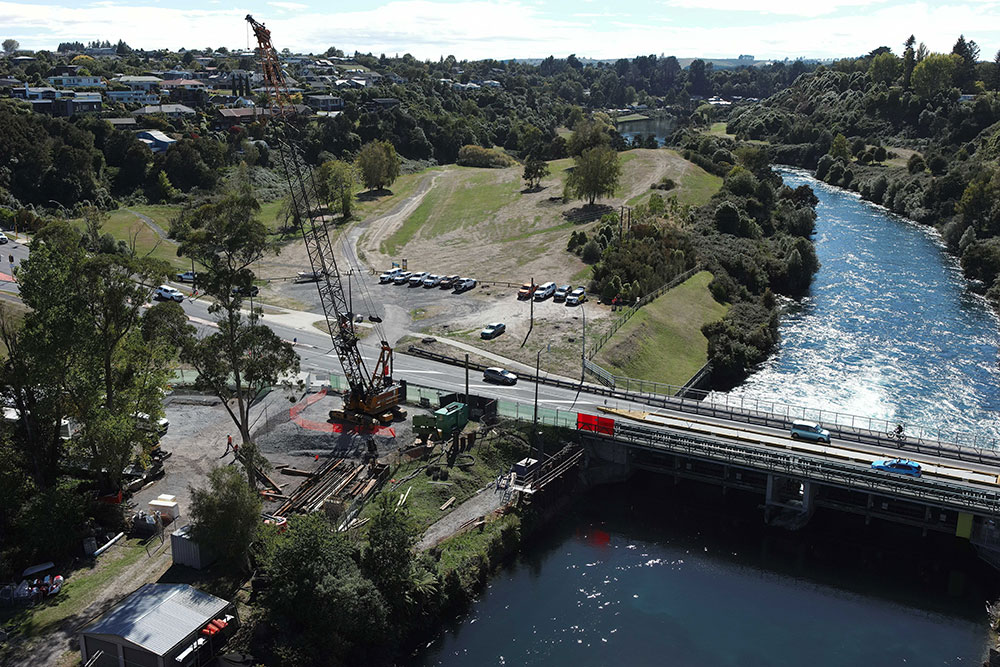

A crane and other specialist equipment is being used to install metal sheets to protect the riverbanks from erosion.

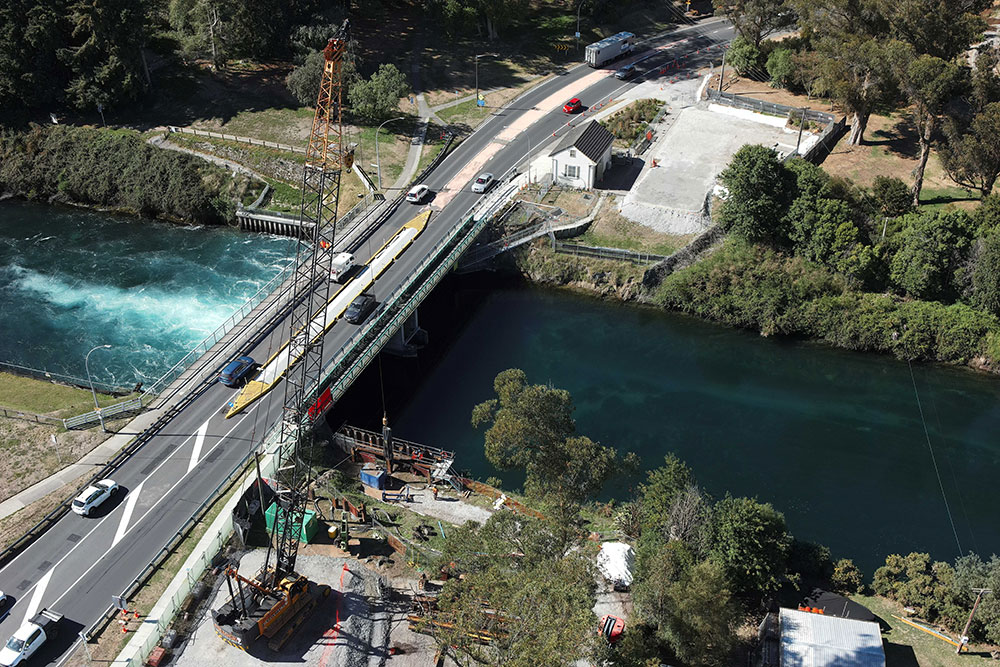

The metal sheets will be installed on both sides of the river, upstream of the Control Gates.
