Opened: 2013
Expanded: 2026
Generating Units: Five
Installed Capacity: 132MW
Average Annual Output: approximately 1,120GWh
Ngā Tamariki Geothermal Station is located 17km northeast of Taupō and generates renewable electricity 24 hours a day.
Originally commissioned with four generation units in 2013, the station was expanded in 2026 with the addition of a fifth unit. The expansion increased the station’s installed capacity from 86MW to 132MW and lifted its average annual generation from approximately 730GWh to 1,120GWh.
Ngā Tamariki provides steady renewable generation that is available around the clock.
Geothermal generation complements weather-dependent renewable sources such as hydro and wind, supporting electricity supply during periods of high demand and when weather conditions affect other forms of renewable generation.
The station’s average annual output of approximately 1,120GWh is the equivalent to enough electricity to power approximately 160,000 average NZ homes.
(Based on an average household usage of 7,000kWh per annum).
The geothermal resource at Ngā Tamariki has been developed in partnership with Tauhara North No.2 Trust, which jointly owns the resource consents, receives a revenue stream from the station and has options to take an equity interest.
Mercury works with Tauhara North No.2 Trust and mana whenua Ngāti Tahu Ngāti Whaoa to support the sustainable management of the geothermal resource and surrounding environment.
The station is located on Wairakei Pastoral Estate, where electricity generation operates alongside farming activities.
Ngā Tamariki uses hot geothermal fluid drawn from deep underground to generate electricity.
The geothermal fluid transfers its heat to a separate working fluid, which drives turbines connected to generators. The geothermal fluid is then reinjected into the reservoir to support its long-term sustainability.
The station has geothermal wells extending to depths of more than 3,000 metres and reaching temperatures of up to 290°C.
Ngā Tamariki reinjects non-condensable gases, primarily carbon dioxide, back into the geothermal reservoir rather than releasing them into the atmosphere.
Mercury was the first electricity generator in New Zealand to undertake this type of reinjection at a geothermal power station.
Following completion of the fifth generation unit, reinjection can be undertaken across all five units. This is expected to help reduce the station’s carbon emissions by 70% by 2030.
Exploration of the Ngā Tamariki geothermal field began in the 1980s.
Mercury commissioned the original four-unit station in 2013. The station was designed using binary-cycle technology, which allows electricity to be generated from lower-temperature geothermal resources.
In 2024, Mercury began construction of a fifth generation unit to increase the station’s renewable output.
Mercury completed the $220 million expansion of Ngā Tamariki in 2026, adding a fifth generation unit to the station.
Construction began in May 2024 and was completed in just under two years.
The project increased the station’s installed capacity from 86MW to 132MW and added approximately 390GWh of average annual generation.
Two geothermal wells were drilled as part of the project: one to supply geothermal fluid to the new unit and another to reinject geothermal fluid and support the long-term sustainability of the reservoir.
Around 300 Mercury people, contractors and consultants contributed to the project, with more than 250,000 hours worked during construction without a serious-harm incident.
The expansion of Ngā Tamariki was one of Mercury’s major renewable generation projects. The following images, videos and updates capture key stages in the construction and commissioning of the fifth generation unit.

May 2024 - Construction begins

Physical construction of the fifth generation unit began in May 2024.

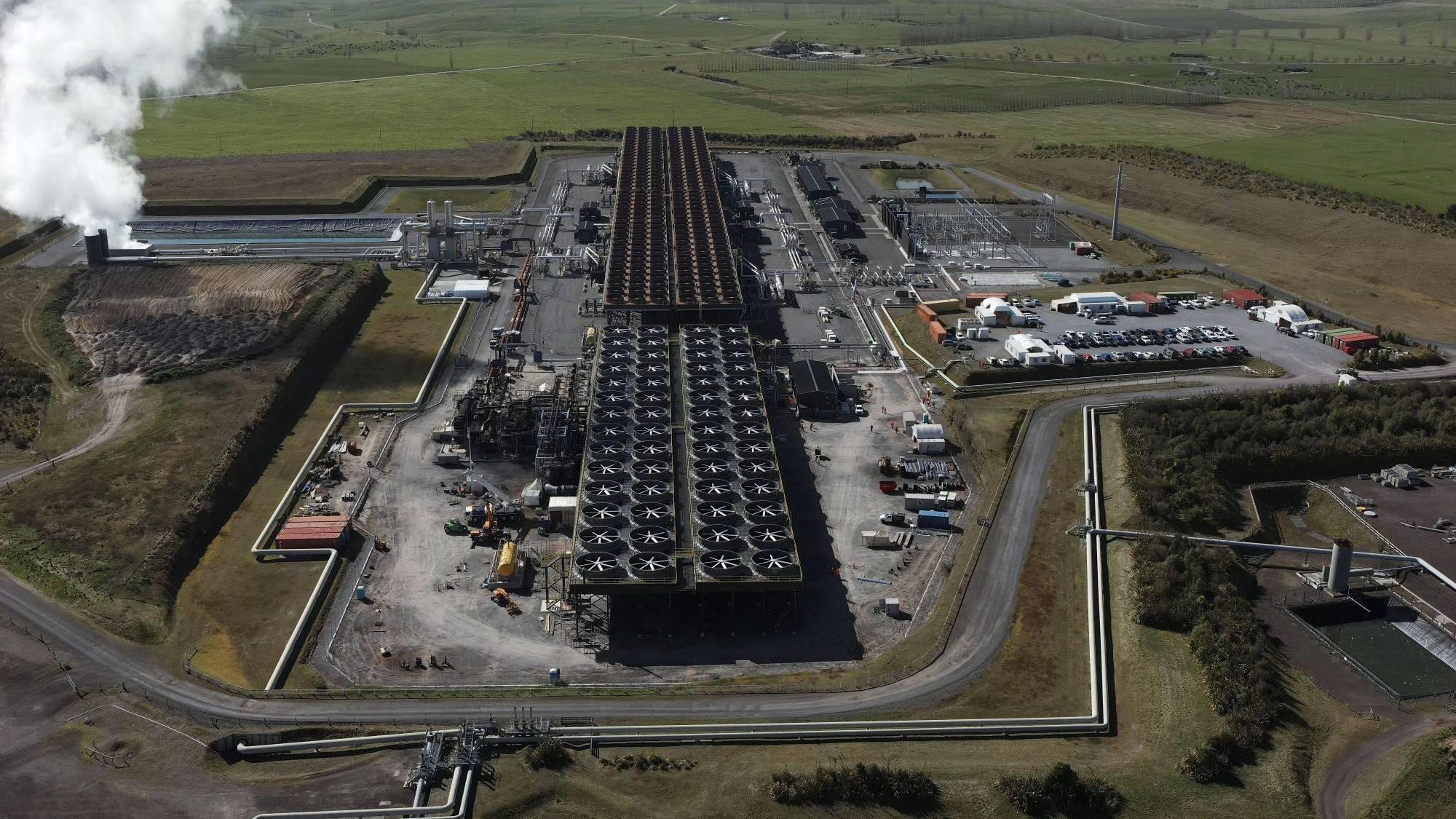

September 2025 - Construction reaches approximately 80%

The fifth generation unit under construction in September 2025, when the project was approximately 80% complete.

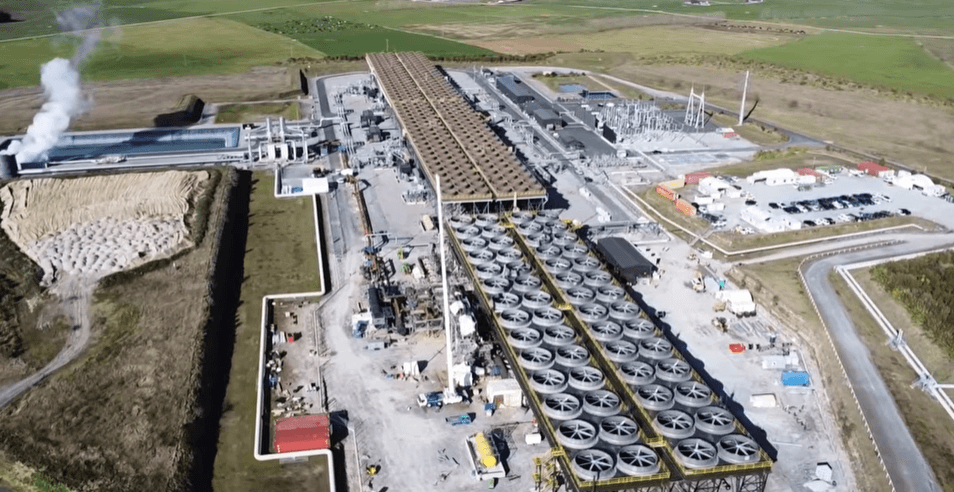

October 2025 - Construction update video

Watch: Ngā Tamariki expansion construction update — October 2025
Note: This video was produced while construction of the fifth generation unit was under way.
January 2026 - First electricity delivered
The fifth generation unit began delivering electricity to the national grid as testing and commissioning progressed.

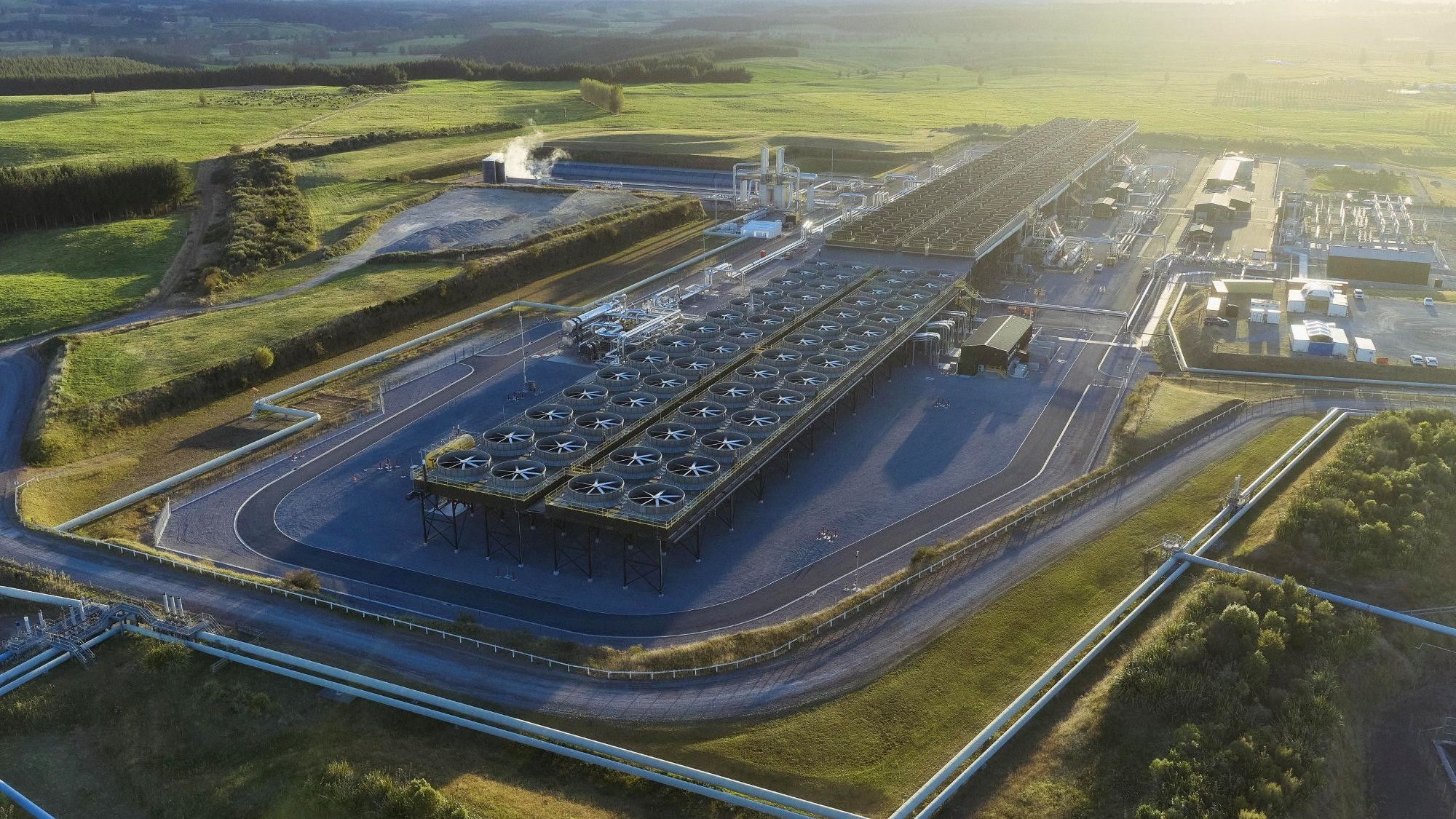

March 2026 - Expansion completed and opened
The completed fifth generation unit was officially opened with mana whenua, commercial partners, landowners, community representatives and members of the project team.

Official opening announcement - 17 March 2026
First power generation - 21 January 2026
Meet Lexi Richards - 9 October 2025
Mercury New Builds and Upgrades
Waikato Times - Geothermal unit turns on the lights as Ngā Tamariki bursts into life - 17 March 2026
Aukaha News - Geothermal sector heats up with $220m expansion and $50m Govt boost - 17 March 2026
New Zealand Herald - Mercury’s Ngā Tamariki geothermal station nears completion - 21 January 2026
Radio NZ - Mercury Energy powers up new geothermal generator - 21 January 2026
Business Desk - Mercury commissions new Ngā Tamariki unit - 21 January 2026
Energy News - Ngā Tamariki expansion reaches hot commissioning milestone - 14 January 2026
Radio NZ - New geothermal generator to produce enough electricity to power Tauranga city - 3 September 2025
Taupō and Tūrangi News - Power plant upgrade nears completion - September 2025
Waikato Times - Full steam ahead for Taupō’s geothermal plant - 30 August 2025
Te Ao Māori News - Central Bay of Plenty iwi help geothermal power station grow - 23 March 2024
